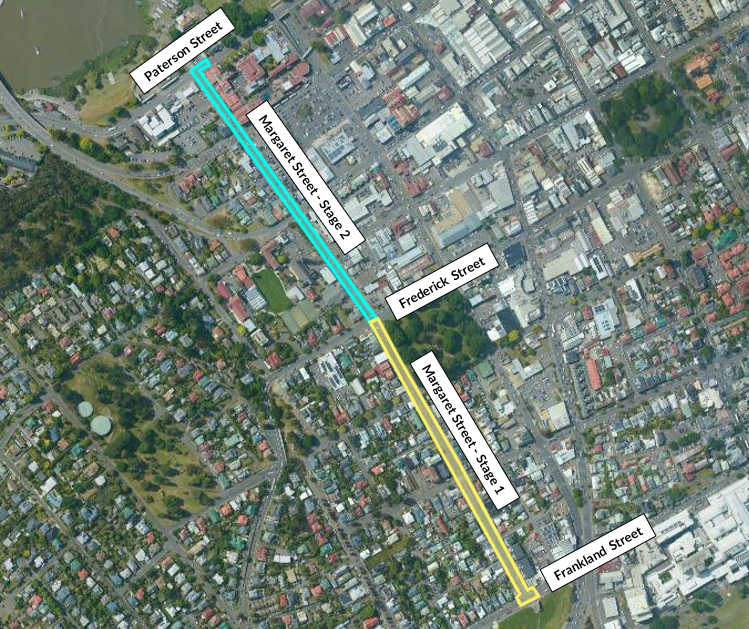

The Margaret Street Reconstruction Project is proposed to be delivered in two stages:
- Stage 1: Frankland Street to Frederick Street
- Stage 2: Frederick Street to Paterson Street
Stage 1 is currently anticipated to commence during Summer 2026-2027, with Stage 2 planned for delivery in the 2027-2028 financial year.
The City of Launceston is currently undertaking consultation with residents, businesses, property owners and other stakeholders within the Stage 1 project area. Feedback received through this process will help inform the detailed design and delivery of the project. Consultation for Stage 2 will be undertaken closer to its planned delivery in the 2027–2028 financial year.
We will continue to provide updates throughout the planning process, with further information about construction timing and delivery made available as details are confirmed.
| Milestone |
Timing |
| Detailed design development - Stage 1 |
In progress |
| Stakeholder consultation - Stage 1 |
In progress |
| Tender for construction advertised - Stage 1 |
Late 2026 |
| Construction contract awarded - Stage 1 |
Late 2026/ Early 2027 |
Stage 1 construction commences
(Frankland Street to Frederick Street) |
Late 2026/ Early 2027 |
| Detailed design development - Stage 2 |
2027 |
| Stakeholder consultation - Stage 2 |
2027 |
| Construction contract awarded - Stage 2 |
2027 |
Stage 2 construction commences
(Frederick Street to Paterson Street) |
2027-28 |
| Project complete |
2028 |
Please note that all dates are indicative and subject to detailed design, procurement processes, approvals and weather conditions. The project timeline will be updated as the project progresses.
